April 2021
Project Achievements
Site
- Installed concrete at loading dock

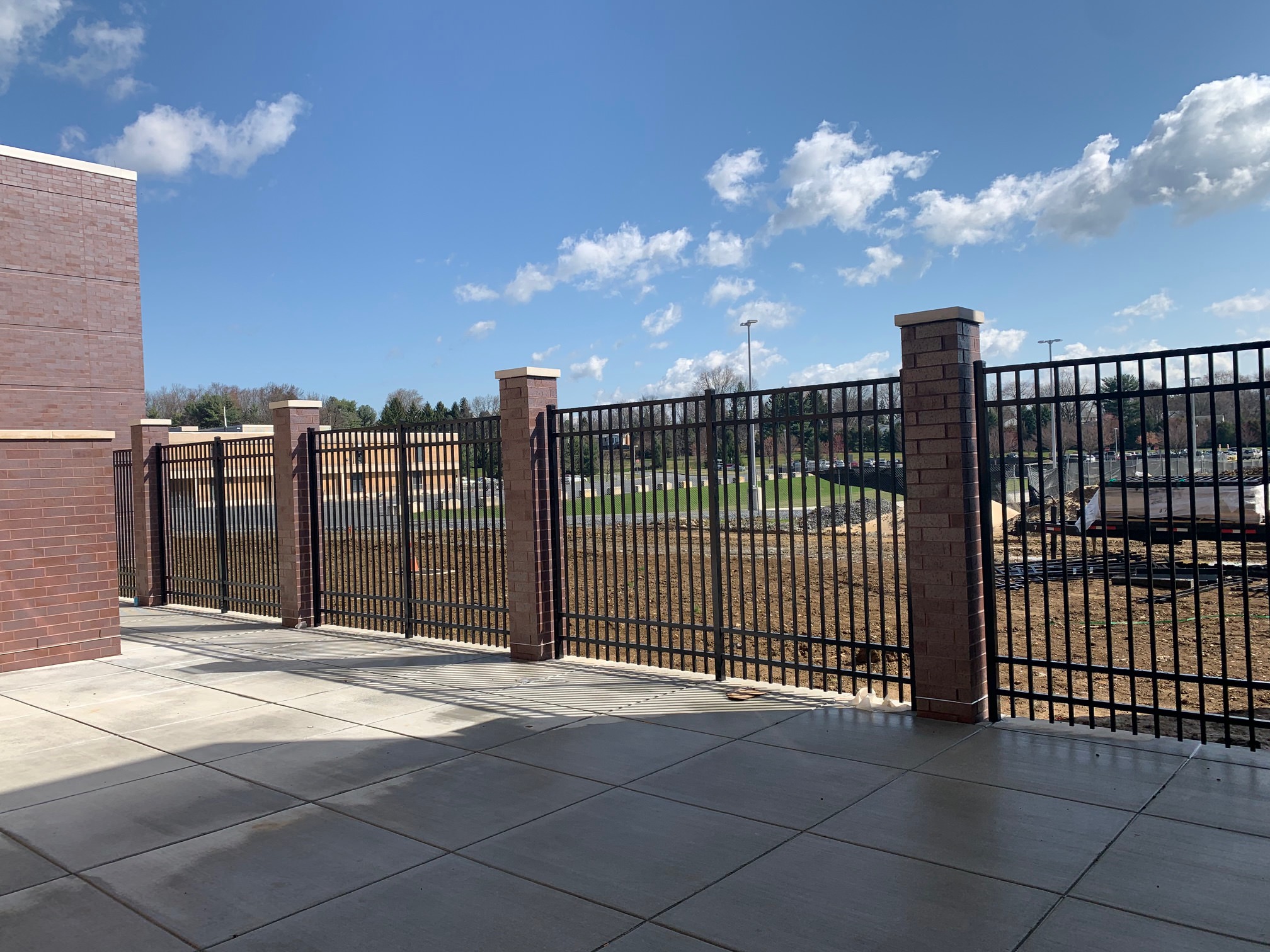

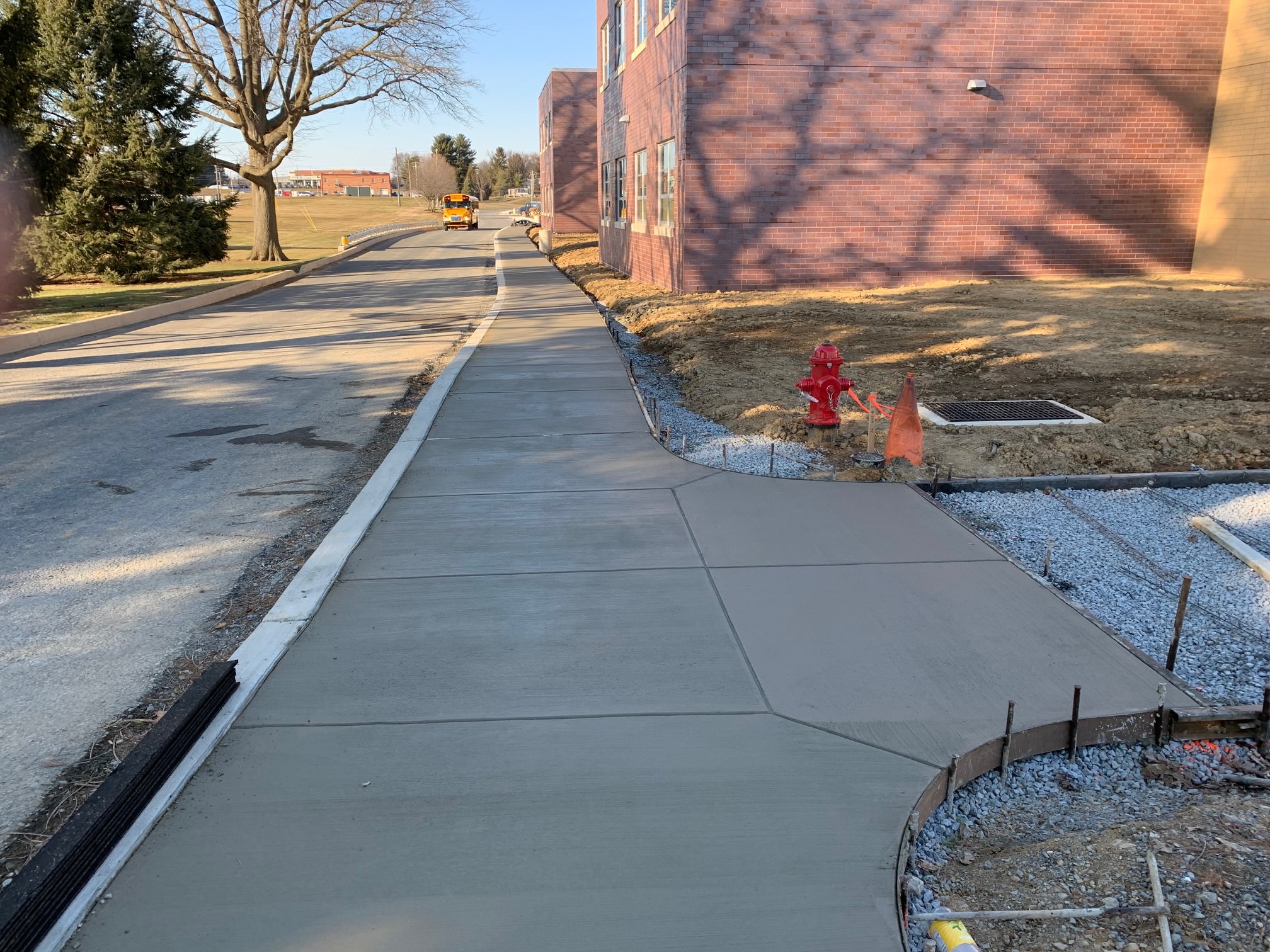

- Installed sidewalks along the west & south elevations
- Coordinated existing Middle School Demolition
GC

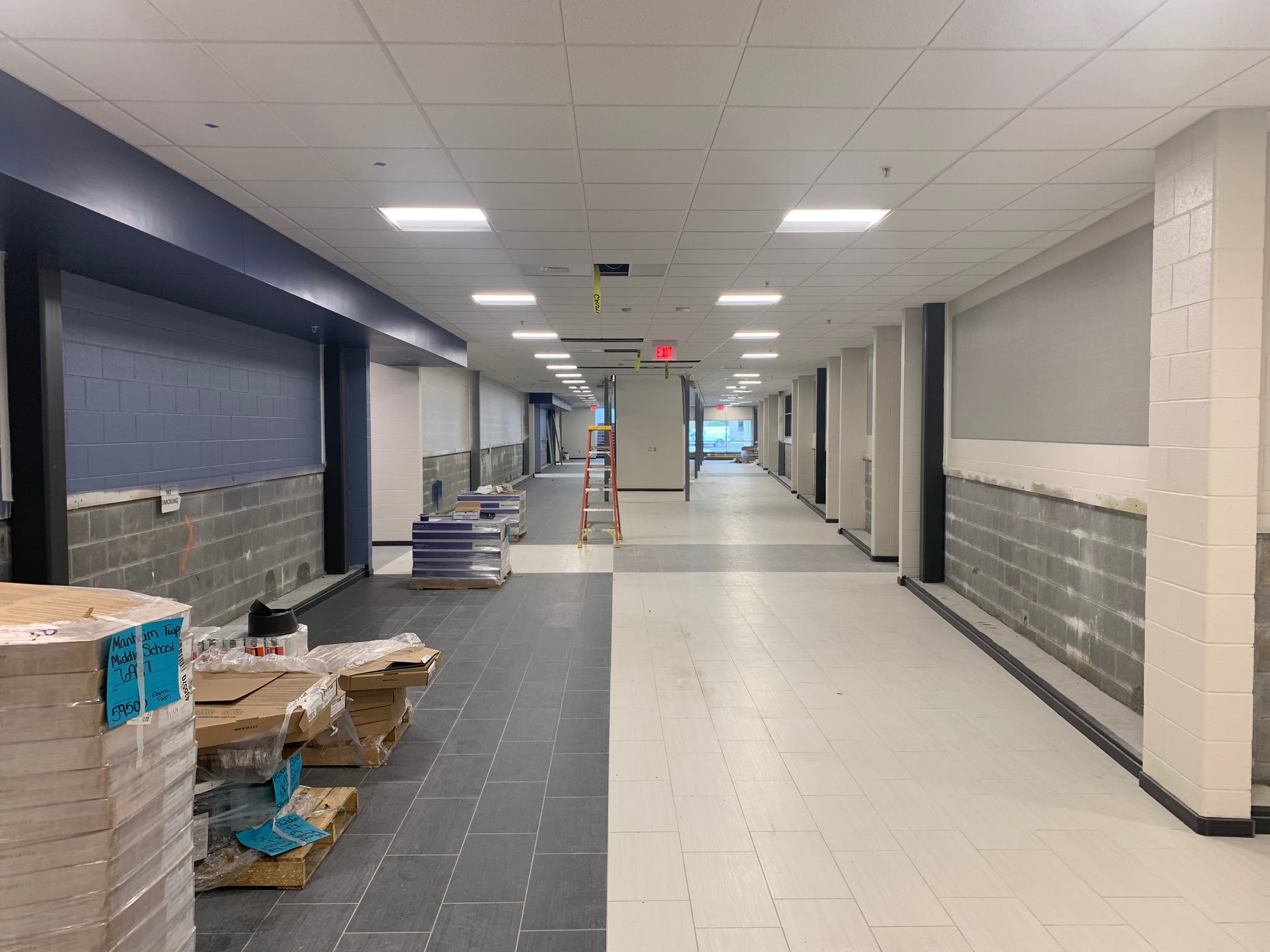

- Completed ceramic floor tile in area D1 & E1 corridors

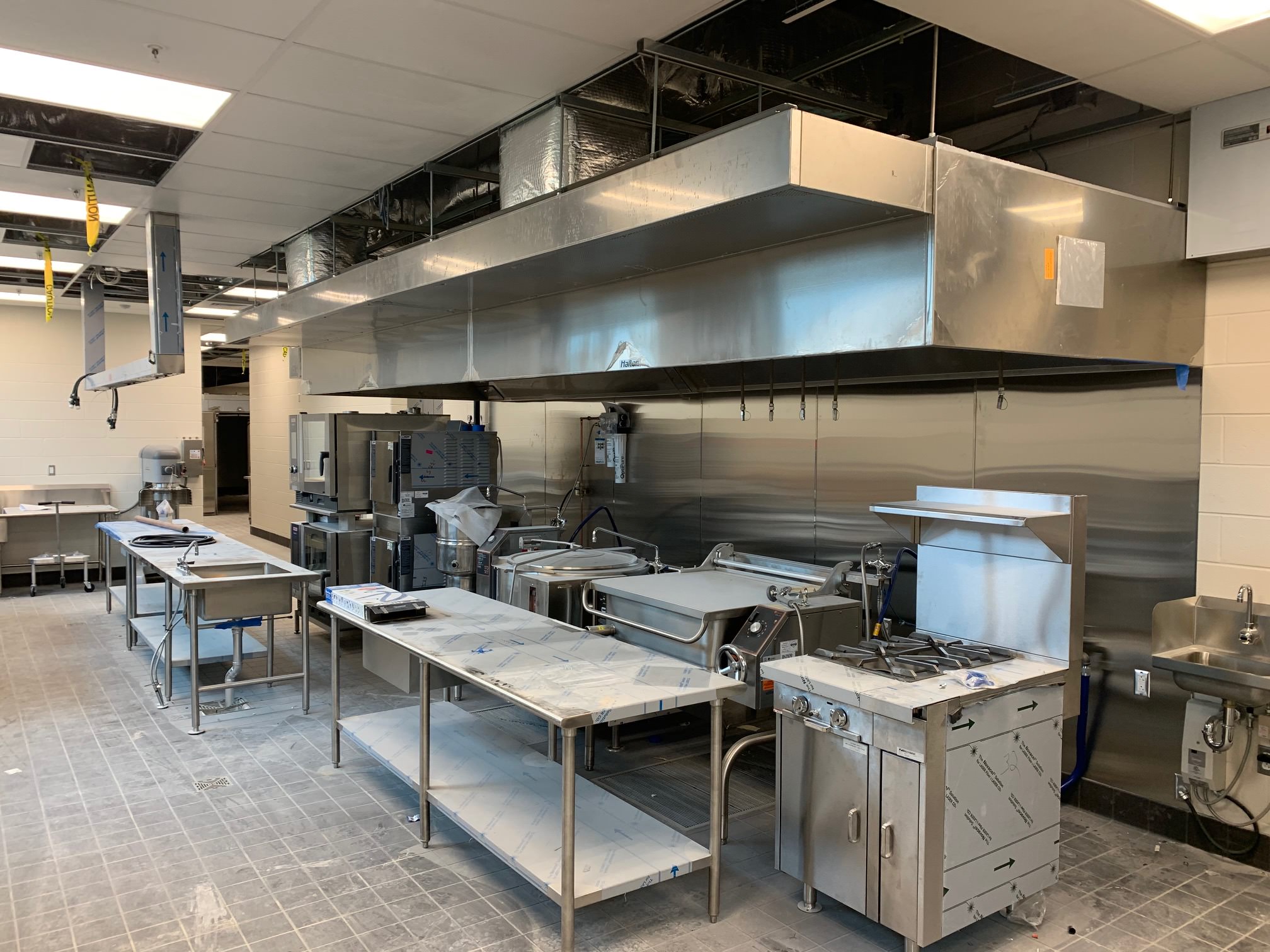

- Completed kitchen & serving equipment installation

- Completed resinous flooring installation in area E

- Completed ceiling tile installation in areas D, E & F

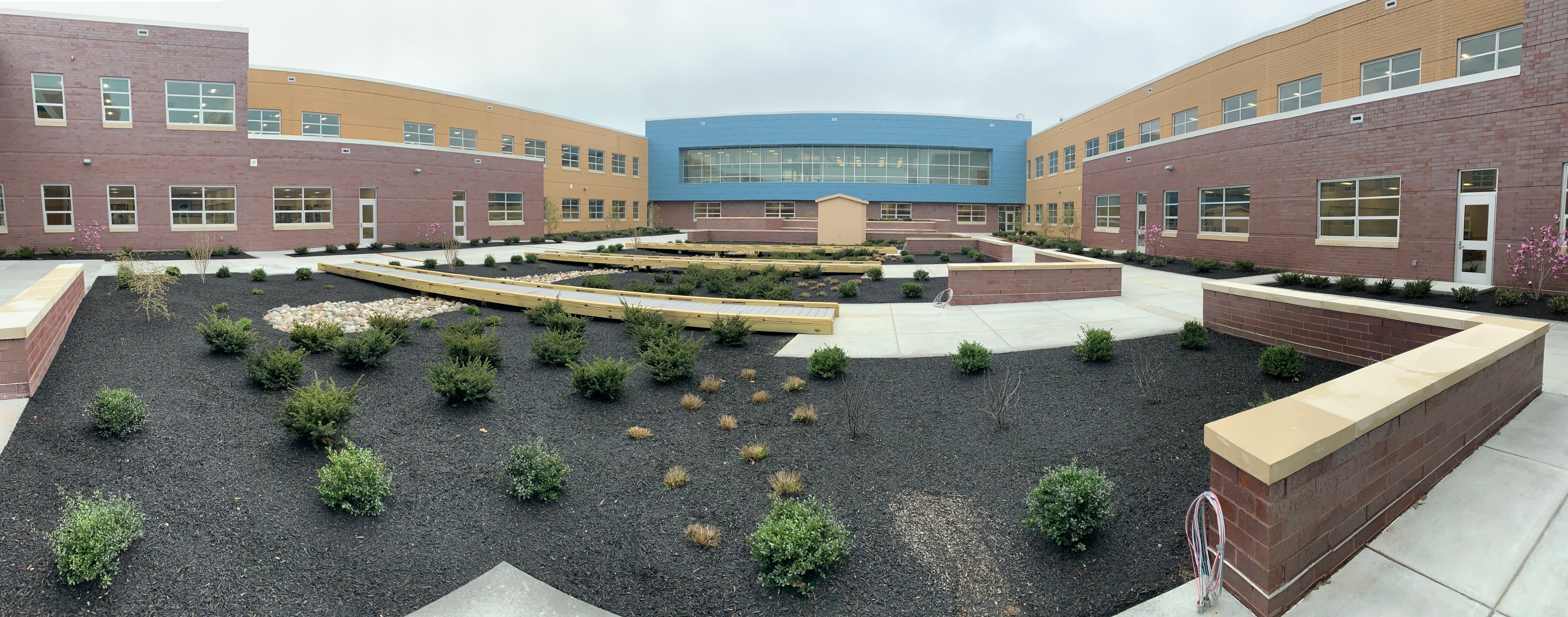

- Completed courtyard landscaping

- Began installing carpet in the classrooms

(75% complete) - Began installing the elevator
Plumber
- Completed setting toilets and sinks throughout the facility
- Continued training for District staff
Electrician
- Finished installing lights
- Continued to terminate data wiring in IDF rooms
- Continued installing outlets and switches throughout the facility
(80% complete) - Continued installing the fire alarm system
(80% complete)
Mechanical
- Began running the permanent HVAC system in area F & the Gym
- Continued installing grills, registers and diffusers throughout the facility
Project Goals (for next month)
- Complete fire alarm system installation
- Complete ceiling tile installation in areas A & B
- Complete interior door installation

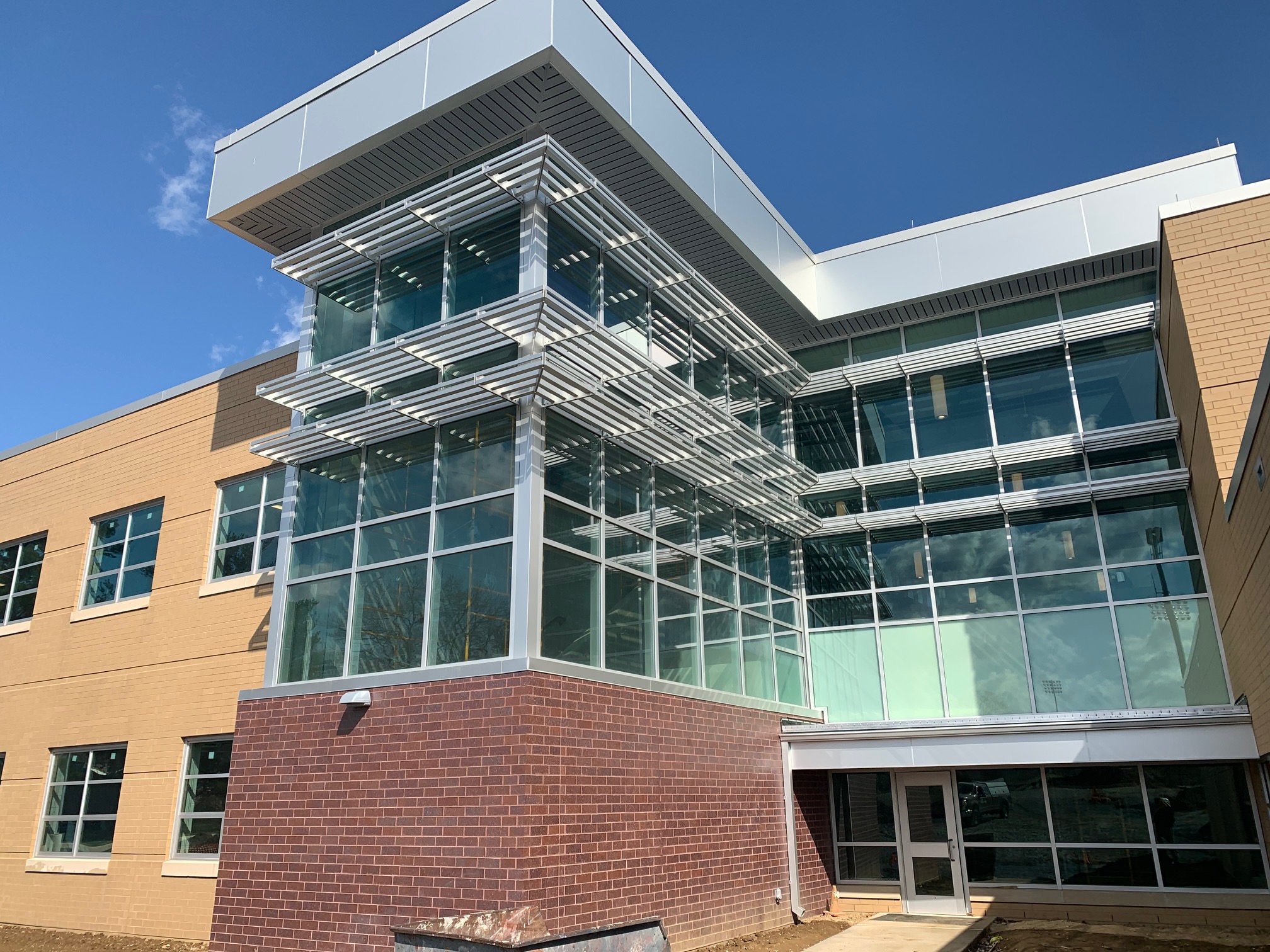

- Complete main entrance

- Complete flooring in the Gym & Black Box
- Begin installing bleachers in the Gym & Black Box
- Begin installing lockers (End of May)
- Prepare field to install sod
- Begin asbestos abatement of the existing Gym
